The project
The facts a future architect or contractor asks for first.
- Property
- 5402 Cameo Road
- Owners
- Rachel and Ben Bennett
- Scope
- New kitchen island with power, new sink and counters, recessed lighting, laundry cabinets and floor
- Architect
- Owen Park, Larkspur Architecture
- Builder
- Stonebridge Builders
- Interiors
- The owners’ design studio; selections approved January 14, 2025
- Permit set issued
- November 22, 2024
- Building permit
- Issued December 9, 2024
- Construction
- February 17 to March 24, 2025
- Final inspection
- Passed March 21, 2025
- Record transferred
- March 24, 2025
Page 2 of 5
Eight sheets, each on the record it explains
The set is in Documents once. Each sheet is also attached to the record a contractor will open when they need it.
| Sheet | Title | Latest issue | Attached to |
|---|
| A-001 | Cover, general notes and code summary | Permit set, November 22, 2024 | The house |

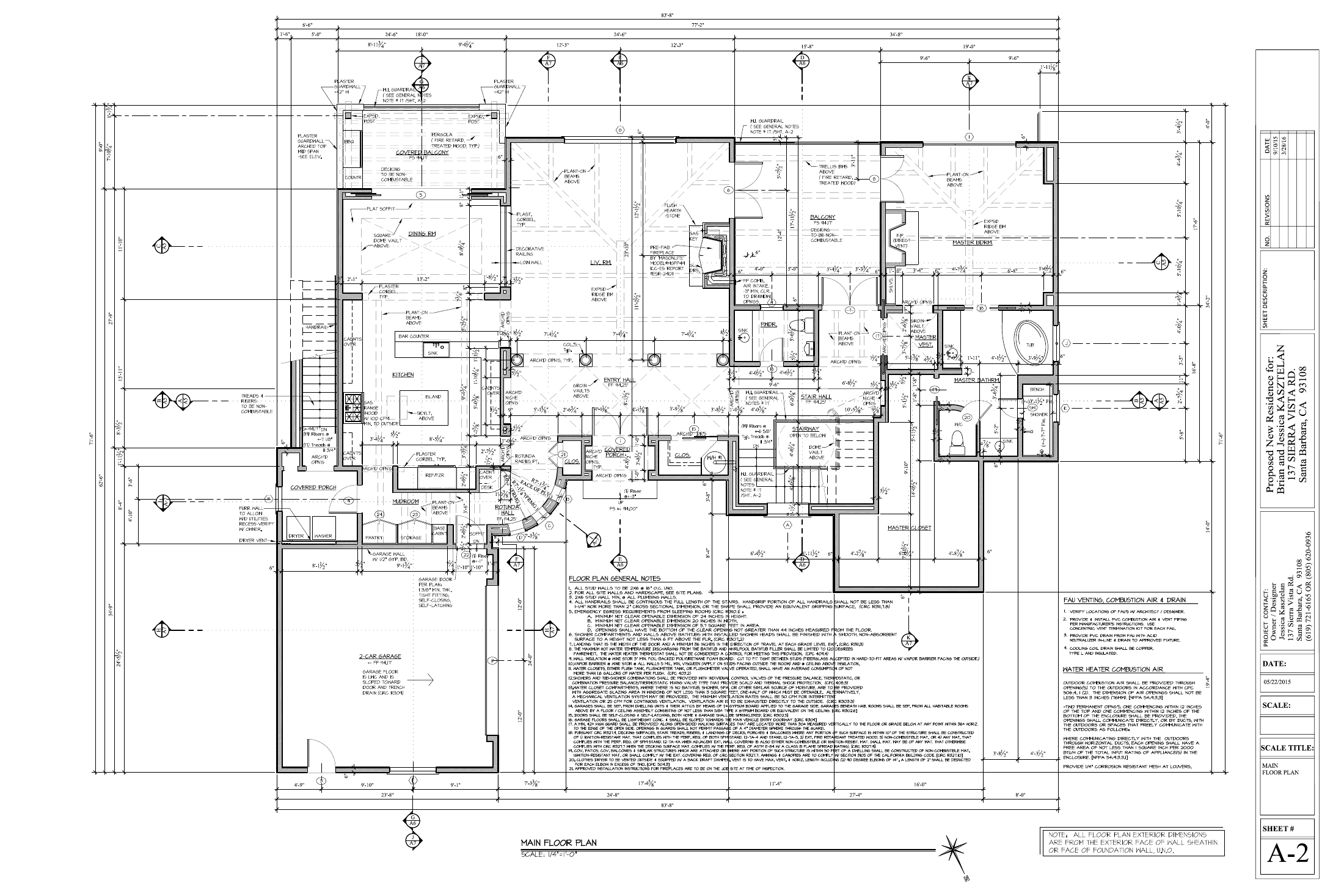

| A-101 | First floor plan, existing and demolition | Permit set, November 22, 2024 | Structure and framing |
| A-102 | First floor plan, new work | Revision 1, January 20, 2025 | Structure and framing |
| A-201 | Kitchen elevations and island details | Revision 2, March 4, 2025 | Kitchen island |
| A-202 | Laundry elevations | Revision 1, February 25, 2025 | Laundry cabinets |
| S-101 | Floor framing under the island | Permit set, November 22, 2024 | Structure and framing |
| E-101 | Power and lighting plan | Revision 2, February 26, 2025 | Electrical |
| P-101 | Plumbing plan, kitchen and laundry | Revision 1, February 25, 2025 | Plumbing |
Page 3 of 5
Four questions from the site, and the answers
Each answer is kept beside the sheet it changed, so the reason is never lost.
| No. | Date | The builder asked | The architect answered | Sheets |
|---|
| 1 | February 19, 2025 | An existing joist sits where recessed light R4 is drawn. | Shift lights R3 to R6 four inches east. Spacing stays even. | E-101 |
| 2 | February 21, 2025 | The island receptacle on the seating side lands in the stool knee space. | Move both receptacles to the island ends, below the counter overhang. | A-201, E-101 |
| 3 | February 25, 2025 | The laundry supply box falls behind the new cabinet side panel. | Move the box six inches toward the window so the shutoffs stay reachable. | P-101, A-202 |
| 4 | March 4, 2025 | The fabricator will not carry a 15 inch stone overhang without support. | Let two flat steel supports into the island top rail. Overhang stays 15 inches. | A-201 |
Page 4 of 5
Where the house departs from the permit set
The four places a drawing alone would mislead someone opening a wall or a ceiling.
| What | As drawn | As built | Recorded on |
|---|
| Recessed lights R3 to R6 | Centered on the room | Four inches east of center, clear of the joist | Recessed lights |
| Island receptacles | One each side | One at each end, below the overhang | Island receptacles |
| Laundry supply box | Centered behind the washer | Six inches toward the window | Plumbing |
| Island overhang | Unsupported | Two flat steel supports in the top rail | Kitchen island |
Page 5 of 5
Closeout
The order the record left the firm.
- March 19, 2025
Closeout record startedSeven records opened from the architect template; sheets attached to each.
- March 21, 2025
Final inspection passedInspection card photographed and added to Documents.
- March 21, 2025
Owner review sentRachel Bennett read the record over the weekend and asked for the stone support detail to be added to the island. It was.
- March 24, 2025
Record transferredAccepted into the Bennetts’ own Hubstone at the walkthrough, with every sheet. Fee and consultant correspondence stayed in the firm’s account.
